NECEC’s First Six Months: An Assessment
Updated October 26, 2026
Key Takeaways
- Six months in operation, the New England Clean Energy Connect (NECEC) transmission project is delivering additive clean-energy imports from Canada
- NECEC’s early outages do not undermine confidence that it will meet its long-term delivery obligations
- The transmission line is poised to reverse recent declines of Net Imports into New England, while lowering New England electricity costs and emissions.
- NECEC illustrates the larger importance of future interregional transmission to assure resource adequacy.
On January 16, 2026, with much fanfare and after a decade of planning, legal wrangling, and construction, the New England Clean Energy Connect (NECEC) transmission line began importing Québec hydropower into New England. Scarcely more than a week later, however, power ceased to flow over NECEC—exports to New England had been curtailed to meet Québec’s domestic provincial electricity demand, which had soared due to Winter Storm Fern’s extremely cold temperatures.1 Detractors pounced, suggesting that NECEC couldn’t be relied upon to deliver the power it was obligated to provide to New England.
Not long thereafter, NECEC came under additional criticism. Because Hydro-Québec imports and exports power from and to New England over a separate transmission line (the “Phase II” transmission line), critics suggested that power exported to Québec via Phase II was offsetting the hydropower imported via NECEC, and that on a net basis NECEC imports were not making a meaningful contribution to New England’s electricity supply.2 NECEC hydropower imports, these critics claimed, were not “additive.”
Six months after NECEC commenced operations, it is possible to put these criticisms into perspective: despite early service interruptions, the project is delivering additive clean-energy imports into New England and underscoring the broader need for expanded interregional transmission to maintain resource adequacy.
NECEC’s Winter Delivery Guarantee
NECEC got its start in 2016 when Massachusetts enacted a statute adding a new section (Section 83D) to its landmark Green Communities Act requiring electric utilities to jointly and competitively solicit proposals for new clean energy resources.3 Section 83D further required the Massachusetts Department of Public Utilities (DPU) to make specific findings prior to approving the resulting NECEC contracts that National Grid, Eversource, and Unitil had jointly procured and awarded to H.Q. Energy Services (U.S.) Inc. (HQUS).4 Among the required findings was a determination by the DPU that the contracts “[g]uarantee energy delivery in winter months.”5 The DPU found winter deliveries were guaranteed because the NECEC contracts schedule the import of specific megawatt hour (MWh) quantities of electricity on a monthly basis,6 impose financial penalties on HQUS if it elects to cease MWh deliveries (unexcused “uncured delivery shortfalls”), and require HQUS to schedule power deliveries to make up for gaps or reductions in MWh deliveries that occur for reasons beyond it’s control (unexcused “curable delivery shortfalls”).7
Involuntary Interruptions of NECEC Import Deliveries
There have been three unexcused, involuntary, curable energy shortfalls during NECEC’s first six months of operation8: April 28 (half-day, no cause attributed); May 19-May 22 (2-3 days, classified as an “emergency”)9; and May 26-June 8 (14 days, attributed to “technical difficulties”)10. Per the NECEC contracts, HQUS must cure these energy shortfalls by increasing deliveries to make up for the undelivered power, either during the same season-peak period of the current year, or the same season-peak period of the following year.11
Voluntary Interruptions of NECEC Import Deliveries
A voluntary decision by HQUS to cease flowing hydropower via NECEC constitutes an uncured delivery shortfallunder the contracts. The occurrence of a an uncured energy shortfall requires HQUS to pay cover damages equal to the incremental cost that National Grid, Eversource, and Unitil incur replacing power that HQUS elects not to deliver, together with the cost of replacement environmental attributes for each MWh delivery missed.
Last January’s Interruptions of NECEC Import Deliveries
The nature of last January’s NECEC power flow interruptions is the subject of a current legal dispute between HQUS and National Grid, Eversource, and Unitil. HQUS’s position is that extreme weather caused by Winter Storm Fern precipitated a force majeure event—an extraordinary event beyond HQUS’s control that prevented it from fulfilling its power delivery obligations under the NECEC contracts.12 National Grid, Eversource, and Unitil, on the other hand, argue in their case filing that last January’s NECEC power flow interruptions constituted voluntary, uncured energy shortfalls that require the repayment of costs they incurred to purchase replacement power and associated environmental attributes.13 HQUS and the utilities agree on one thing, however: under the NECEC contracts force majeure events suspend HQUS’s delivery obligations.14
Other than the disputed shortfalls that are currently being litigated, there has been an excused nine-day outage April 8-16 for planned maintenance,15 and 17 days when NECEC power deliveries were unexpectedly interrupted by forced outages due to equipment failures. (A second planned outage is scheduled for November 5-17.)

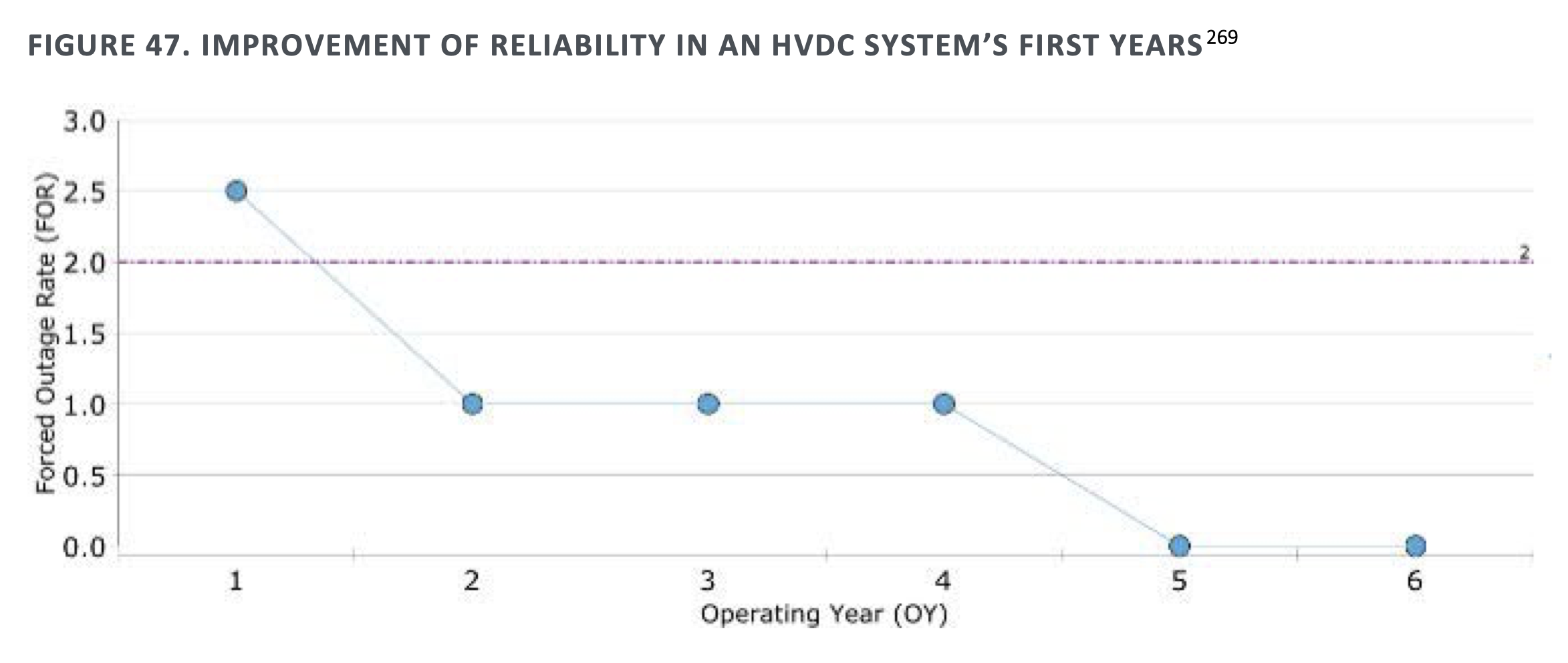

According to a 2023 Brattle Group/DNV report on the reliability of VSC-HVDC (Voltage Source Converter-High Voltage Direct Current) transmission lines like NECEC, forced outages on new HVDC lines are to be expected—forced outage rates are higher for newly commissioned equipment, but decrease over time.16 According to the report, “[the] number of outages is higher during the first few years, then reduce[s] steadily to a low level for the majority of the equipment’s lifetime, only to increase again towards the end of life as ageing-related effects increase the failure rate again.”17
NECEC is Poised to Reverse Recent Declines of Net Imports into New England

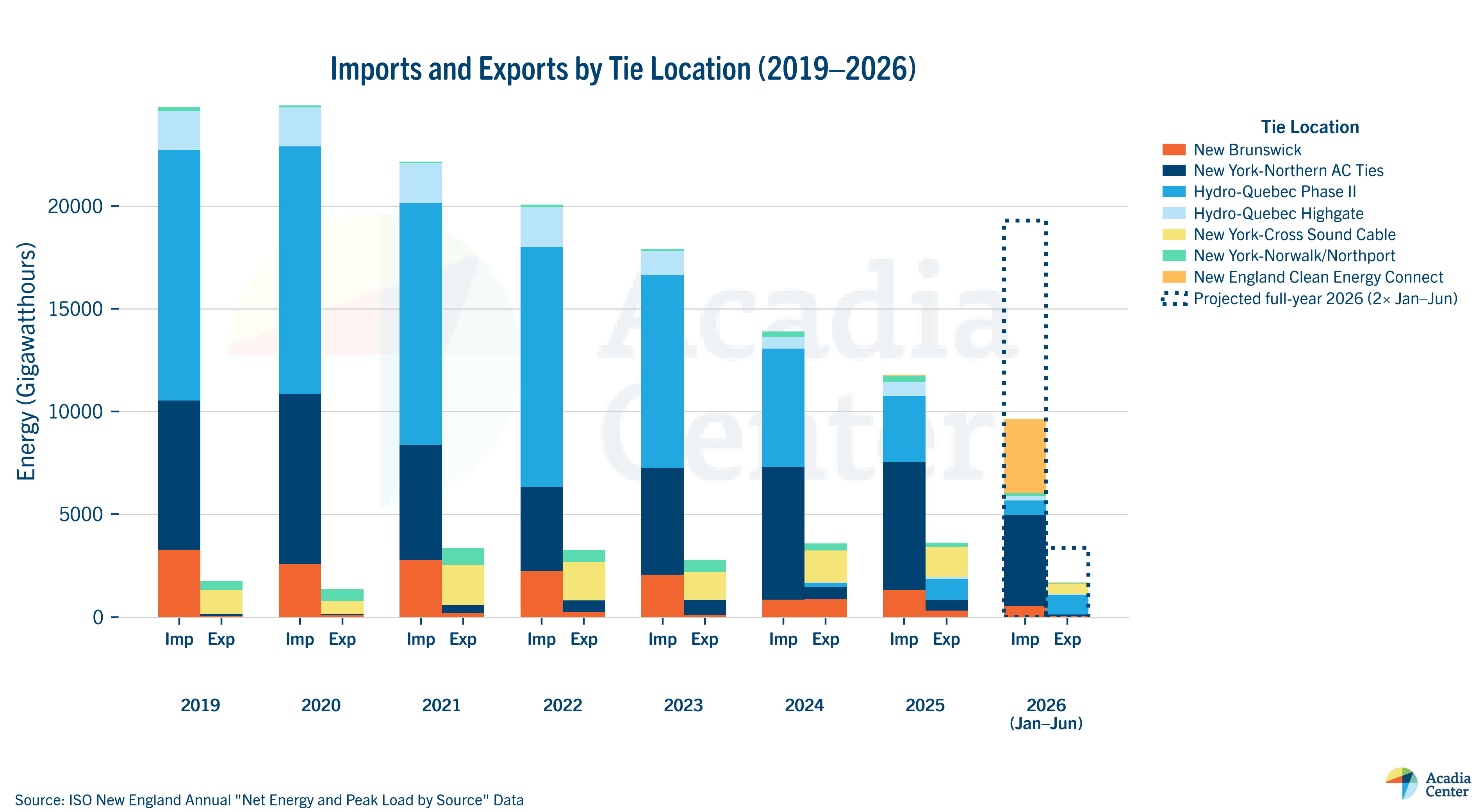

NECEC’s excused and unexcused outages notwithstanding, it remains on track to meet its annual 9.55 TWh delivery obligation: as of July 16, NECEC had delivered 3.9 TWh into New England. A review of historic and current ISO New England (ISO-NE) external interface data through June indicates, moreover, that NECEC hydropower imports are not being materially offset by power exports to Québec via the Phase II line but are “additive.”

ISO-NE power Import and Export data show that Net Imports (i.e., Imports less Exports) have been declining since 2022, though not always owing to reduced Imports from Québec: in 2021 and 2022 Net Imports declined due to reduction in Imports from New York via the New York Northern AC tie. Since 2023, however, continuing declines in Net Imports have been due to reductions in Imports from Québec—specifically, reductions in Hydro-Québec Phase II Imports. Those Phase II reductions were due to an ongoing drought that began in early 2023.18 Despite successive declines in Phase II Imports from 2023 through 2025—a trend that appears likely to be continued this year as well—the projection of 2026 Imports and Exports into New England based on the first six months of the year indicates that 2026 Net Imports are on track to increase to their highest level since 2022, and that this reversal in Net Import declines will be due to the additive contribution of Imports received via NECEC.19 This has been borne out by ISO New England’s Internal Market Monitor (IMM): the IMM’s Spring 2026 Quarterly Market Report, which states that ”[a]verage net imports more than doubled from 798 MW per hour in Spring 2025 to 1,625 MW per hour in Spring 2026, driven by flows over the new NECEC line. Net imports accounted for 13% of the region’s energy supply compared to 7% in Spring 2025.”20
NECEC Imports are Reducing New England Electricity Prices and Emissions
NECEC is also having a real impact reducing both the cost and emissions associated with the production and consumption of electricity in New England. According to ISO-NE’s Internal Market Monitor, NECEC imports “displaced more expensive generation particularly combustion turbines and steam turbines.”21 Moreover, every MWh of NECEC imports is derived from 100% hydropower, and the NECEC contracts require the associated environmental attributes to be created, tracked, recorded and transferred in compliance with NEPOOL GIS (New England Power Pool Generation Information System) operating rules.22 According to the DPU, this requirement ensures that the utilities are purchasing “clean energy generation as defined by statute, and not system energy that contains non-clean energy generation.”23
Proposed Maine–New Hampshire Transmission Upgrades Will Ease Congestion for NECEC and Maine Onshore Wind
One early criticism of NECEC—that it would increase transmission congestion in Maine—has come to pass. According to ISO-NE’s Internal Market Monitor, the transmission interface limiting power flows from Maine into New Hampshire (the “Maine-New Hampshire interface”) rarely bound before the NECEC became operational, but last winter was constrained in more hours than previous years.24 Fortunately, the Maine-New Hampshire Interface is the subject of ISO-NE’s first Longer-Term Transmission Planning (LTTP) procurement. The RFP included an energy standard that assumed the dispatch of future northern Maine onshore wind output at 100% of nameplate value, while taking the existing and post-NECEC transfer capabilities of ISO-NE interfaces into account.25 On July 28th ISO-NE announced the preferred solution it had selected from among those submitted in response to the first LTTP Request for Proposals (RFP).26 The selected solution will be capable of accommodating 1,200 MW of onshore wind in both ISO-NE’s energy and capacity markets.27
New England is Resource and Transmission Constrained
The nexus of NECEC as an import-only transmission resource bringing 9.55 TWh per year into New England, and the objective of the first LTTP RFP to bring 1.2 GW of additional onshore wind power online, demonstrates the role that transmission plays in ensuring that the region will have sufficient resources to serve current and future demand for electricity. One way New England meets that need is power imported via regional interties—the interregional transmission that connects the region to New York and Canada. Last year Net Imports accounted for 7% of the power New Englanders consumed.28 In turn, New York and Canada rely on power that New England exports to them.29
A February 2026 North America Reliability Corporation (NERC) Interregional Transfer Capability (ITC) Study found that energy transfers via interregional transmission “play an increasingly pivotal role in supporting energy adequacy.”30 The NERC ITC study found that New England would benefit from the addition of 700 MW of interregional transfer capability with Canada, split between Québec (400 MW) and the Maritime Provinces (300 MW).31 That increase, NERC said, would “resolve all resource deficiencies identified in [its] energy margin analysis,” and added that the then just-commissioned NECEC “is likely to address a significant portion of this need.”32
NERC’s consideration of whether new interregional transfer capability a region would be a “technically prudent addition” depended on satisfying two conditions: first, a determination that the subject region was “resource deficient,” and second, a determination that a neighboring region had surplus energy to share with the deficient region after meeting its own needs.33 In light of it of Québec’s ongoing drought, and HQUS’s additional commitment to deliver hydropower into New York City via the Champlain Hudson Power Express (CHPE) transmission line commissioned last May34 questions about the province’s ongoing ability to share surplus energy with neighbors after meeting its own needs will persist. The answer likely lies in Hydro-Québec’s plans to expand and diversify its generation portfolio beyond hydropower: by 2035 Hydro-Québec is planning to build 10 GW of wind power generation,35 3 GW of solar generation,36 and to implement up to 3.6 GW of energy efficiency.37 Together, these resource additions would exceed 40% of the nameplate capacity of Hydro-Québec’s current 37.4 GW resource portfolio.38 In addition to these ambitious goals, a new tentative agreement announced August 17th between Newfoundland and Labrador Hydro and Hydro-Québec would provide Hydro-Québec access to a potential 10,000 MW of projects to be constructed in Labrador–6,915 MW of them planned projects, and 3,850 MW from potential projects currently under study. Beyond Labrador and Québec, the potential for wind resource development in Nova Scotia is staggering–the province boasts 40 GW of potential generation capacity within Wind Energy Areas currently designated by the Canada-Nova Scotia Offshore Energy Regulator, with a total estimated technical wind resource potential exceeding 400 GW.39
Regional Reliability Depends on Power from Resources Beyond New England’s Borders and the Interties to Deliver It
New England is resource constrained and currently relies on neighboring New York and Canada to meet its energy requirements. The extent of NECEC’s contribution in meeting those requirements will become clear over the remaining nineteen-and-a-half-year term of its current contracts. Based on its first six months of operation, however, it is apparent that early criticism of NECEC has been premature, if not largely misplaced. Consumers are right to raise questions and seek answers – they are paying for the electricity system after all. And the adversarial nature of the process leading to the construction of NECEC shows how much the public needs and deserves credible responses to questions and concerns. The danger of the post-January criticism leveled at NECEC isn’t merely that it may not accurately characterize NECEC’s performance to-date, but that it could cast doubts on the ability of resources outside of New England to meet the challenge of maintaining resource adequacy here in the region, within the ISO-NE control area. New York, Québec and the Maritimes, and New England each have their own potential to develop native resources, and each have native demand to serve. At a time when resource adequacy is a primary concern for all four regions, the use of every resource, no matter where it located, must be optimized, and that can only be accomplished by increasing the transfer capacity of existing interregional transmission40 and constructing new interties to transfer power from geographically distant resources. The need to maintain reliability transcends borders. Early criticism of NECEC should not put that in doubt.
